International office relocation vs. domestic — what actually changes when the move crosses a border
The same end goal, a very different planning exercise — where the two moves overlap, where they diverge, and what that means for your timeline, your budget and who you need running it.

When a company outgrows its premises, the decision to move can feel straightforward — until the new address is in another country. Domestic and international office relocation share the same end goal: get the business operating from a new building with the least possible disruption. But the planning, the compliance and the logistics behind each are worlds apart, and understanding those differences before you start is what separates a move that runs to plan from one that drifts into cost overruns and a longer-than-expected gap in normal working.
This guide sets out where a cross-border office move genuinely differs from a domestic one — not to make it sound harder than it needs to be, but so the planning reflects the real shape of the job rather than a domestic move with a longer flight at the end of it.
Scale versus complexity: why the two moves aren't the same job
A domestic office move — across the city or to a different state — sits inside a familiar legal and logistical framework. You're dealing with carriers you already know, a shared currency, the same regulatory environment throughout, and a planning horizon most facilities teams can hold in their heads without specialist help.
An international office relocation is a different category of challenge. You aren't just transporting furniture and equipment; you're moving company assets across a customs border, navigating import rules that vary by destination, and coordinating work across time zones on a planning horizon that has to accommodate several workstreams running in parallel rather than in sequence. The cost structure carries more moving parts, and the margin for error is smaller — a mistake that costs a day domestically can cost considerably more once a shipment is sitting at a foreign port.
The differences below aren't abstract. Each one is a decision point that shapes your budget, your timeline and the kind of partner you need running the move.
Regulatory, customs and legal compliance
For a domestic office move, the regulatory list is short and familiar: building permits, landlord approvals, a lease surrender agreement, and possibly a local authority notification. These are standard steps your building manager or solicitor can usually handle without specialist input.

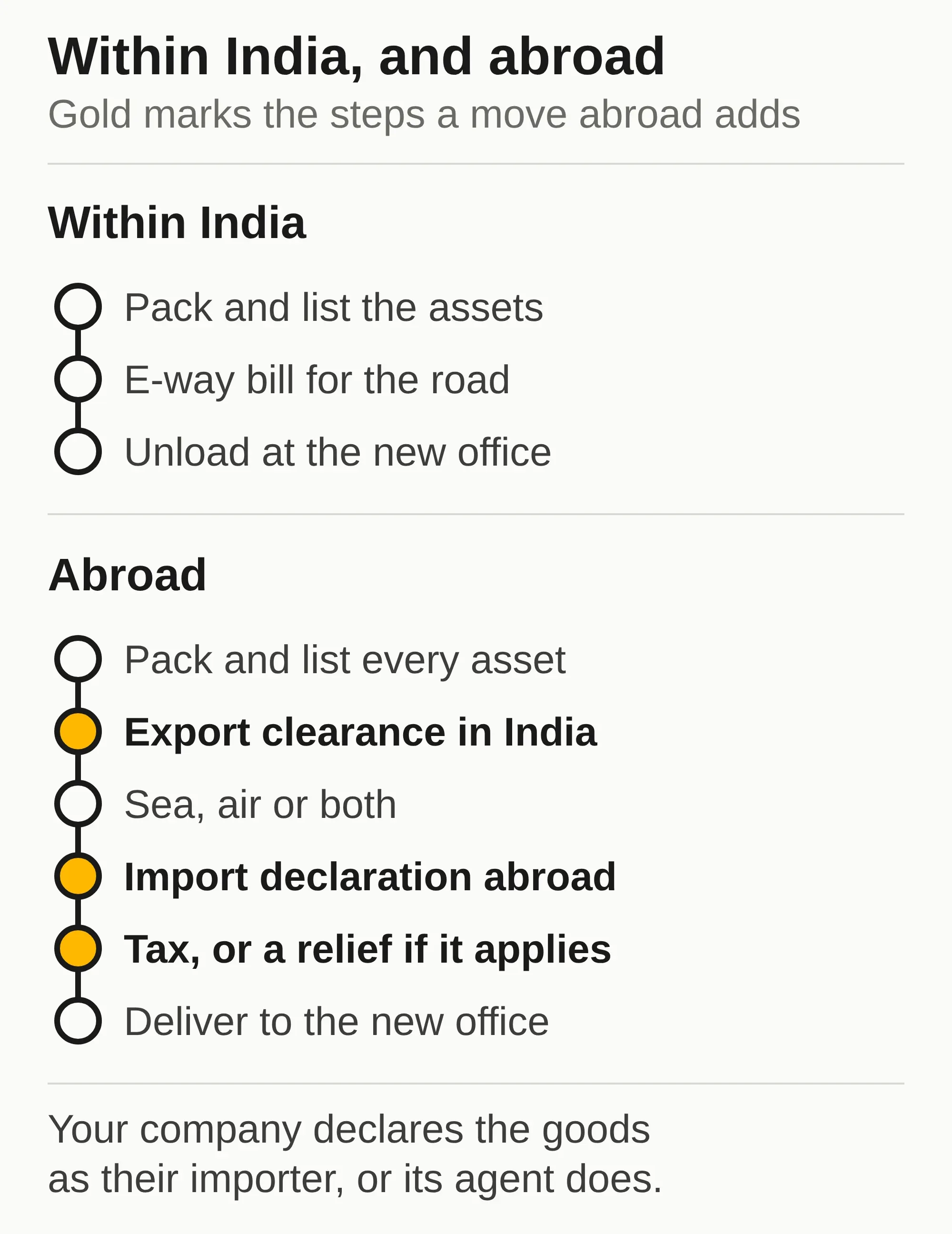

International relocation adds a compliance layer with real consequences for getting it wrong. Every item crossing a national border has to be declared, categorised and valued, and depending on the destination you may run into some combination of the following:
- Customs duties and import charges on office equipment, furniture and electronics — often applied even to used goods
- Restricted or prohibited items — certain batteries, chemicals and electronic components may need special permits, or be barred outright
- Temporary-import documentation for anything travelling out and back to the origin country
- Registering a legal entity in the destination country before goods can be formally received there
- Extra duty treatment or inspection that several markets apply specifically to second-hand office furniture and equipment
None of this is a formality to leave until the last week. A single incorrect commodity code on a commercial invoice can hold an entire shipment at port, and the lost productivity that follows costs considerably more than the underlying duty ever would. Working with a mover who has a dedicated customs coordinator on staff, rather than one who hands the documentation to a third party, is what keeps errors caught on your desk rather than at the border.
IT equipment and data: the rules a domestic move never touches
Moving IT equipment within one country is primarily a physical logistics problem — careful inventory, anti-static packing, de-installation and reinstallation at the other end. The equipment stays inside the regulatory environment it was bought in throughout, with nothing extra to approve.
Cross-border IT moves add a compliance dimension that regularly catches experienced operations teams off guard. Hardware containing encryption technology — which spans most modern laptops, servers, network switches and storage arrays — can be subject to export licensing depending on where it was manufactured and where it's going; equipment with US origins, for example, can fall under American export control regimes such as the Export Administration Regulations. This isn't a footnote: getting it wrong can mean the whole shipment being held at the point of departure rather than simply delayed.
Moving servers and storage devices across a border can also trigger data protection obligations at the destination — the EU's GDPR, Singapore's PDPA and India's DPDP Act each apply differently depending on where the data, and the people it describes, are headed. IMove's own operations are GDPR-compliant, with formal documentation available on request, and your legal and IT teams should assess data residency and cross-border transfer requirements before a single storage device leaves the building — in some cases wiping data before export and restoring it from backup at the destination is the safer route.
Customs authorities also expect a detailed, serialised asset inventory for every piece of electronic equipment crossing the border — make, model, serial number and declared value against each one. It's a genuine documentation exercise, and building it into the plan from day one is far easier than trying to compile it during the final week of packing.
Timeline and project management: how the planning window changes
Timeline is where the gap between domestic and international office relocation becomes most visible. A domestic move can often be phased over a single weekend, with staff back at their desks the next working day. An international office move attempted with that same informal approach runs into trouble quickly — not because of bureaucracy for its own sake, but because customs documentation, freight booking, destination-office preparation, IT infrastructure setup and staff communications all depend on each other, and a delay in any one of them ripples through the rest.
Professional move management exists to coordinate exactly those interdependent workstreams, and a phased handover — critical systems first, non-essential assets last — is what protects daily operations rather than risking everything on one cutover date. Structured this way, office moves carry a zero-business-downtime guarantee, because continuity is planned for from the outset rather than hoped for on the day.
A practical sequence for an international office move looks roughly like this:
- Appoint a single internal project lead and decide, early, what's moving, what's being disposed of and who's relocating
- Carry out a full asset inventory — furniture, IT hardware, servers, archives — recording enough detail on electronics to feed straight into customs paperwork
- Bring your international relocation specialist in early; the later they're engaged, the fewer options remain around freight booking and customs pre-clearance
- Start customs documentation in parallel with freight booking, not after it — this is the step most companies underestimate
- Confirm your freight method and book capacity, particularly on routes where demand is seasonal
- Prepare the destination office — IT infrastructure, utilities, fit-out, address registration — while the shipment is still in transit, rather than waiting for it to land
- Plan a phased handover rather than a single cutover, so a delay in one part of the move doesn't stall the whole business
Cost structures: what changes at the border
A domestic office move's cost is fairly predictable — a removal company, packing materials, transport, and any fit-out or reconnection work at the other end. Surprises tend to be minor.
International relocation introduces cost categories that simply don't exist domestically, and they're the ones early budgets consistently miss. Freight method is the single biggest variable: sea freight suits high-volume shipments and is markedly cheaper at that scale, while air freight is charged on chargeable weight, the actual or volume weight, whichever is higher, and suits a small, time-critical consignment far better than a full office fit-out. Most corporate relocations split the two — bulk furniture and non-urgent assets by sea, IT equipment and business-critical items by air.
Destination-country import duties on commercial equipment and furniture add to the landed cost of certain asset categories, and apply to second-hand goods as well as new ones — budget for this before the move, not after clearance has already happened. If the destination office isn't ready the moment the origin office vacates, the shipment needs somewhere to sit in the meantime, and transit storage — warehousing, in-and-out handling, and looking after the goods for the extra time they're sitting there — is a cost first-draft budgets routinely leave out. Your mover's local partner at the destination handles port clearance, local delivery and installation, and their fee is a legitimate, unavoidable part of the job; a reputable partner puts it in the initial quote rather than surprising you with it on an invoice.
A move that spans several months also carries currency exposure. Get every quote in the currency you'll actually pay in, and for a large shipment on a route where the exchange rate genuinely moves the total, ask whether a forward currency arrangement makes sense before you commit.
Choosing the right partner — and what actually decides the outcome
For a domestic office move, most reputable commercial movers can do the job competently: a track record with commercial clients, appropriate liability protection for goods in transit, and availability on your timeline is usually enough to choose on.
International relocation calls for a specialist, and the difference isn't simply one of scale — it's a different discipline. Look for in-house customs coordinators rather than a freight forwarder who subcontracts the documentation to someone you've never spoken to; customs errors are the most common, and the most preventable, cause of delay on an international office move. Look, too, for an established network of agents at the destination rather than ad hoc subcontractors sourced once the shipment has already arrived — that's what makes genuine door-to-door accountability possible, with one company owning the outcome at both ends. Ask directly who handles last-mile delivery and installation at the destination, and what that relationship actually is.
IT equipment needs its own operational procedures — anti-static packing, climate-controlled transport for servers and storage hardware, and asset-level documentation accuracy — rather than generic fragile-item handling applied across the board. And the best partners assign one project manager from first consultation through to final installation: a single point of contact who understands both ends of the move and owns the timeline throughout, rather than a set of handoffs nobody is accountable for.
At IMove, work at the destination is handled by our own in-house coordinators, working with a vetted agent network and local destination partners.
The gap between domestic and international office relocation isn't really a matter of distance — it's a different planning exercise altogether. Companies that approach a cross-border move with a domestic mindset tend to underestimate the timeline, the documentation and the cost variables that only exist once a shipment crosses a customs border. Starting early, bringing in the right specialist from the outset, and treating customs paperwork as a first-priority workstream rather than a final formality are the decisions that most reliably determine whether the move runs to plan. Everything else — freight method, cost structure, IT compliance — falls into place more easily once those three are settled.
Common questions about domestic versus international office moves
What's the single biggest planning difference between a domestic and an international office move?
Time, and how many things have to happen in parallel, because an international move adds customs documentation, freight booking, destination-office preparation and IT compliance as workstreams that all depend on each other, while a domestic move keeps the same currency, carriers and regulatory environment from start to finish. A domestic move can often be planned and run within a matter of weeks. The realistic planning window for an international move stretches out considerably further than a domestic move would ever need.
Do we need a dedicated customs specialist for an international office relocation?
Yes, because customs is the part of an international office relocation most likely to cause delay when it's approached generically, and every workstation, server and box in the move depends on the export and import documentation being right before anything is loaded. A mover with in-house customs coordinators, rather than one who outsources the documentation to a third party, catches errors before a shipment ships rather than after it's already sitting at a border.
What happens to our IT equipment and data when they cross a border?
Hardware containing encryption technology can be subject to export controls depending on its country of origin and destination, and servers or storage devices carrying personal data can trigger data protection obligations at the destination — from GDPR in the EU to equivalent regimes in Singapore and India. Involve your legal and IT teams early enough to assess this before a single device is packed.
How do you keep the business running while the office itself is mid-move?
Through a phased handover rather than a single cutover date, so critical systems move first and non-essential assets last, which means a delay in any part of the move holds up only that part and doesn't put the rest of the business at risk while the office is between addresses. That's the difference between a move that protects daily operations and one that gambles on everything landing on schedule at once.
